A design that passes every electrical review can still stall on the production line if the parts on the bill of materials aren't available when the factory needs them. Electronic component sourcing determines whether a board moves from prototype to shipping product on schedule. This guide covers how to source components for production, structure a bill of materials that tolerates supply disruption, and plan around component lifecycles so obsolescence doesn't turn into an unplanned respin. The strategies apply to a first production order or to sourcing across several product revisions.

Key Takeaways

Why Electronic Component Sourcing Matters Early in Hardware Design

Component sourcing decisions made during schematic capture affect whether a product ships on time. For example, a part chosen because a single distributor had ten units in stock during prototyping can stall a production run six months later. Engineers who treat sourcing as a downstream procurement problem are counting on someone else to catch availability issues after the design is already locked.

Engineering and procurement each own a piece of the problem, and neither can solve it alone:

  • Engineering selects components based on electrical fit, footprint, and second-source availability, since only engineering can judge whether a substitute part will work in the circuit.
  • Procurement manages supplier relationships, negotiates pricing, and tracks purchase orders once parts are chosen.
  • A component picked without procurement input on lead time can pass every design review and still block production weeks later.

A part that's easy to find in prototype quantities can become a liability at volume. Manufacturers may allocate a component to larger customers first when demand rises, even if a distributor stocked enough for a ten-unit prototype run. Engineers designing for production should confirm sufficient manufacturer capacity and more than one stocking distributor, not just current spot availability.

Build a Smart Component Sourcing Strategy

A sourcing strategy turns component selection into a repeatable process the whole team can follow, rather than a case-by-case judgment call. Electronic component sourcing works best when the same criteria apply to every part on a design, not only the ones that turn out to be hard to find later.

  • Reliable suppliers: Buy through authorized distributors and franchised channels rather than gray-market brokers. Authorized channels provide stronger traceability and warranty protection and reduce counterfeit risk.
  • Production-volume availability: Confirm a distributor or manufacturer can supply the full production quantity, not just a handful of prototype units.
  • Lead time evaluation: Check current lead times against the project schedule before locking in a part; a 30-week lead time on a microcontroller can delay a launch by months if it surfaces late.
  • Widely available components: Favor parts stocked by multiple distributors and produced by more than one fab when a suitable option exists.
  • Single-source avoidance: Flag components with only one approved manufacturer or distributor, and identify a compatible alternate before that source becomes a blocker.
  • Price versus availability: A cheaper component that's chronically backordered costs more in schedule delay than a pricier part that ships on request.

Applying these criteria at the schematic stage, instead of after layout is finished, keeps sourcing a solvable problem rather than a production-blocking surprise.

Reduce BOM Risk Before Production

BOM management is the practical mechanism for reducing sourcing risk once a design moves toward production. A bill of materials listing only a single manufacturer part number per line leaves no fallback when that part goes on allocation or gets discontinued.

BOM Field What It Should Include Why It Matters
Approved Vendor List (AVL) Every authorized manufacturer and distributor. Restricts buyers to authenticated, traceable sources.
Alternate Part Numbers A form-fit-function substitute for critical parts. Gives procurement an option when a part is backordered.
Lead Time Current lead time from each approved distributor. Flags schedule risk before the part is ordered.
Lifecycle Status Active, NRND, or EOL flag per line item. Surfaces obsolescence risk before manufacturing.
Sourcing Notes Why a part was chosen, and any known constraints. Preserves context for future revisions.

An approved vendor list (AVL) restricts sourcing to manufacturers and distributors the team has vetted for authenticity and quality. Pairing an AVL with authorized distributors, rather than open marketplaces, protects against counterfeit parts entering the supply chain, particularly for high-demand ICs during a shortage.

Plan for Component Lifecycles and Obsolescence

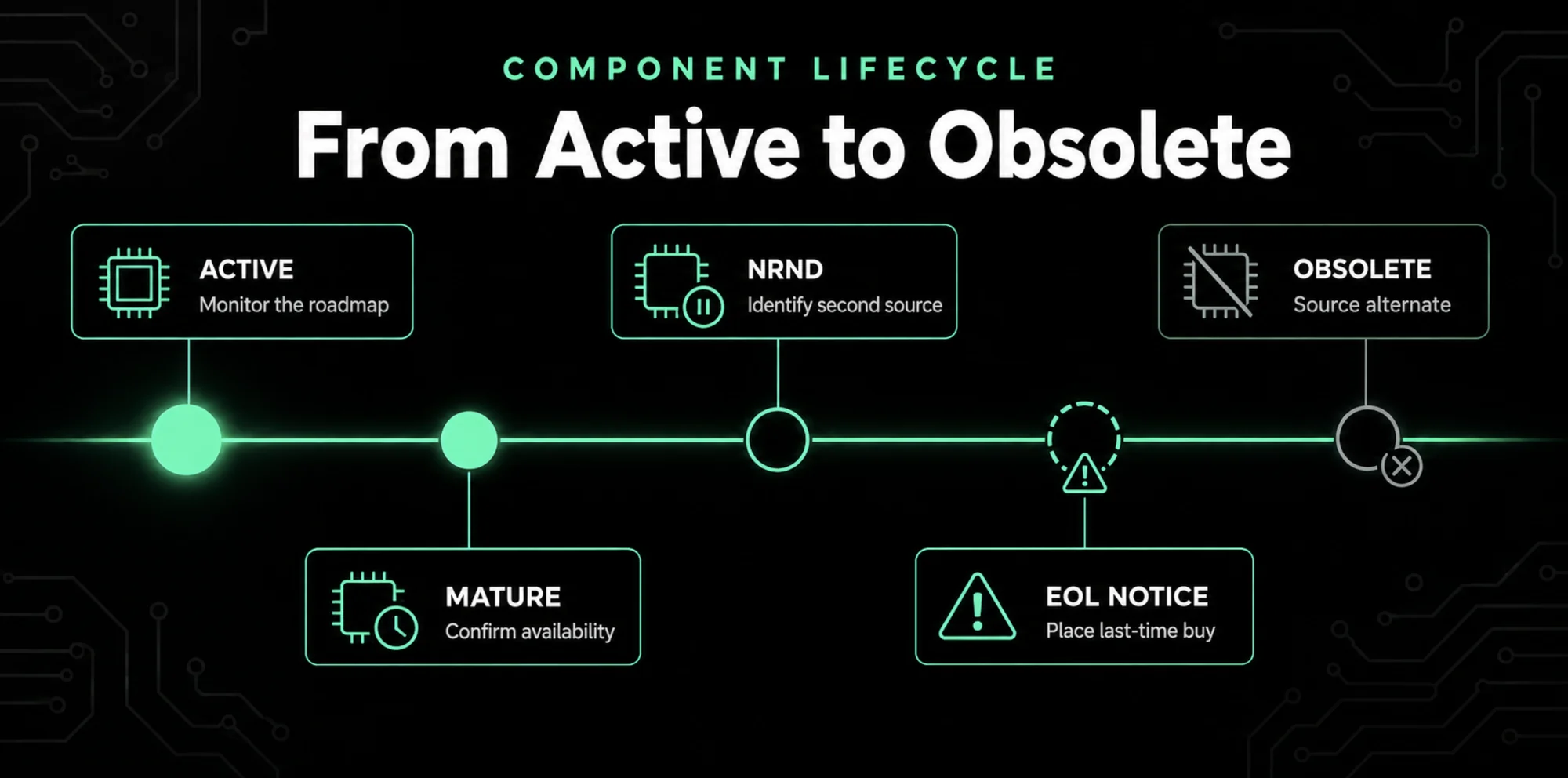

Component lifecycle timeline from active to obsolete, with the sourcing action to take at the active, mature, NRND, EOL notice, and obsolete stages.
Where to act at each stage of a part's journey from active to obsolete

Every electronic component moves through a lifecycle that starts at introduction and ends at discontinuation. Component obsolescence follows a predictable pattern across that lifecycle, and lifecycle management means tracking where each part on a design sits before that pattern turns into a shortage.

Lifecycle Stage What It Means Sourcing Action
Active / Introduction Manufacturer is producing and promoting the part. Safe to design in; monitor the roadmap.
Mature Production continues, but marketing focus has shifted to newer parts. Confirm long-term availability before a new design.
Not Recommended for New Designs (NRND) Manufacturer fills existing orders but discourages new use. Avoid for new designs; identify a second source.
End-of-Life (EOL) Notice Manufacturer announces a final order date, typically 6 to 18 months out. Place a last-time buy or qualify a replacement.
Obsolete Manufacturer no longer produces or supports the part. Source vetted excess inventory or move to an alternate.

Manufacturers typically issue an end-of-life notification with a final order date, but an EOL notice alone doesn't guarantee time for a redesign, especially for a part with a long lead time already stretching procurement thin.

  • Set up lifecycle alerts. Distributor platforms and manufacturer newsletters can flag EOL and NRND status changes for parts on an active BOM.
  • Qualify a second source early. Testing an alternate part before it's needed avoids a rushed requalification during a shortage.
  • Plan redesign windows deliberately. When a critical part reaches EOL with no substitute, budget engineering time for a planned respin instead of reacting after stock runs out.
  • Consider a last-time buy. With no acceptable alternate, ordering enough inventory to cover the production run can bridge the gap until a redesign is feasible.

Products with multi-year production runs need lifecycle review at every design revision, not only the initial launch, to catch obsolescence before it turns into a shortage mid-production.

Build a More Resilient Hardware Supply Chain

Supply chain resilience comes from combining the practices above into a consistent process rather than a one-time check at launch. Supply chain risk changes constantly: a component that was widely available last quarter can enter allocation after a factory disruption or a demand spike elsewhere in the industry.

  • Monitor supplier risk continuously. Track distributor stock levels, lead times, and manufacturer announcements for every part on an active BOM, not just the ones already flagged as risky.
  • Diversify suppliers where it makes sense. Qualifying a second source for critical components reduces exposure to a single factory or region, though it trades some BOM simplicity for lower risk.
  • Improve engineering-procurement communication. Regular syncs between the two teams surface sourcing problems while there's still time to requalify a part.
  • Review sourcing risk during design reviews. A sourcing checkpoint at every design review, not only the final one before production, catches problems before they compound.
  • Plan for future revisions. A product shipping successfully today will need a BOM refresh eventually, and documenting sourcing decisions now makes that refresh faster.

How Collaborative Platforms Support Sourcing

Platforms like Flux support such sourcing practices inside the design environment itself. Shared component libraries keep footprint and sourcing data consistent across a team, so an engineer selecting a part sees the same approved options as everyone else on the project. Revision tracking preserves the reasoning behind a component swap, which matters when a second-source part gets qualified months after the original decision.

Automated rule checks catch footprint mismatches before a substitute part reaches layout, and DFM review flags manufacturability issues before files go to a fab. None of this replaces procurement's supplier negotiations, but it keeps engineering's side of sourcing organized enough that procurement works from accurate, current information.

Build Sourcing Into the Design Process, Not Just Procurement

Effective electronic component sourcing, done early and revisited each revision, keeps a product manufacturable for years instead of one production run. Flux keeps sourcing data attached to the design itself, from shared component libraries to BOM-level revision history, so engineering and procurement work from the same information. Start designing with Flux.

FAQs

Profile avatar of the blog author

Gabriel Hacohen

Gabriel Hacohen is an electrical engineer with deep expertise in analog circuitry, medical devices, high-performance computing, and semiconductors. He holds both Bachelor's and Master's degrees in Electrical Engineering and has written for companies including NVIDIA, Cadence, Synopsys, Netflix, and Autodesk.

Go 10x faster from idea to PCB
Work with Flux like an AI hardware engineer—handling complex tasks, learning your standards, explaining its decisions, and collaborating with you at every step.
Illustration of sub-layout. Several groups of parts and traces hover above a layout.
Design PCBs with AI
Introducing a new way to work: Give Flux a job and it plans, explains, and executes workflows inside a full browser-based eCAD you can edit anytime.
Screenshot of the Flux app showing a PCB in 3D mode with collaborative cursors, a comment thread pinned on the canvas, and live pricing and availability for a part on the board.
Design PCBs with AI
Introducing a new way to work: Give Flux a job and it plans, explains, and executes workflows inside a full browser-based eCAD you can edit anytime.
Screenshot of the Flux app showing a PCB in 3D mode with collaborative cursors, a comment thread pinned on the canvas, and live pricing and availability for a part on the board.
Design PCBs with AI
Introducing a new way to work: Give Flux a job and it plans, explains, and executes workflows inside a full browser-based eCAD you can edit anytime.
Screenshot of the Flux app showing a PCB in 3D mode with collaborative cursors, a comment thread pinned on the canvas, and live pricing and availability for a part on the board.

Related Content

Design for Manufacturing: How to Move from Prototype to Production

Design for Manufacturing: How to Move from Prototype to Production

A practical guide to Design for Manufacturing (DFM) that helps hardware teams transition from validated prototypes to scalable, production-ready products.

Profile avatar of Gabriel Hacohen
Gabriel Hacohen
|August 26, 2026
Designing for Compliance: PCB Layout Tips for EMI & FCC/CE Testing

Designing for Compliance: PCB Layout Tips for EMI & FCC/CE Testing

Practical PCB layout and design strategies to reduce EMI and improve the chances of passing FCC and CE compliance testing on the first attempt.

Profile avatar of Gabriel Hacohen
Gabriel Hacohen
|August 26, 2026
Hardware Feasibility: Cost Engineering and Part Selection

Hardware Feasibility: Cost Engineering and Part Selection

A guide to evaluating hardware feasibility through requirements definition, component selection, BOM cost estimation, power budgeting, and early manufacturing risk identification.

Profile avatar of Gabriel Hacohen
Gabriel Hacohen
|August 26, 2026
How to Choose the Right Architecture for Robotics, Wearables & IoT

How to Choose the Right Architecture for Robotics, Wearables & IoT

Learn how to choose the right hardware architecture by comparing the unique engineering priorities of robotics, wearables, and IoT products.

Profile avatar of Gabriel Hacohen
Gabriel Hacohen
|August 26, 2026
Hardware Team Collaboration: ECAD, MCAD & Firmware Workflows

Hardware Team Collaboration: ECAD, MCAD & Firmware Workflows

How electrical, mechanical, and firmware teams can build effective collaboration workflows through design reviews, revision control, and engineering change management.

Profile avatar of Gabriel Hacohen
Gabriel Hacohen
|August 26, 2026
Hardware Prototyping: From Concept to a Tested PCB

Hardware Prototyping: From Concept to a Tested PCB

A practical guide to hardware prototyping—from breadboard to custom PCB, through structured testing, verification, validation, and iterative revision.

Profile avatar of Gabriel Hacohen
Gabriel Hacohen
|August 26, 2026
How to Convert PDF Schematics into Editable EDA Files Using AI

How to Convert PDF Schematics into Editable EDA Files Using AI

Step-by-step guide to converting flat PDF schematics into editable PCB/EDA files using an AI-assisted schematic conversion workflow, with validation and export considerations for KiCad and Altium.

Profile avatar of Gabriel Hacohen
Gabriel Hacohen
|August 20, 2026
The RF Engineer's Guide to Designing Printed Trace Antennas

The RF Engineer's Guide to Designing Printed Trace Antennas

Practical RF layout guide for designing printed PCB trace antennas, covering antenna topology, stackup data, 50 Ω feed lines, solder mask expansion, keepouts, and common copper-placement mistakes.

Profile avatar of Gabriel Hacohen
Gabriel Hacohen
|August 20, 2026
